THE OBEROI DEVELOPMENT
About the Project

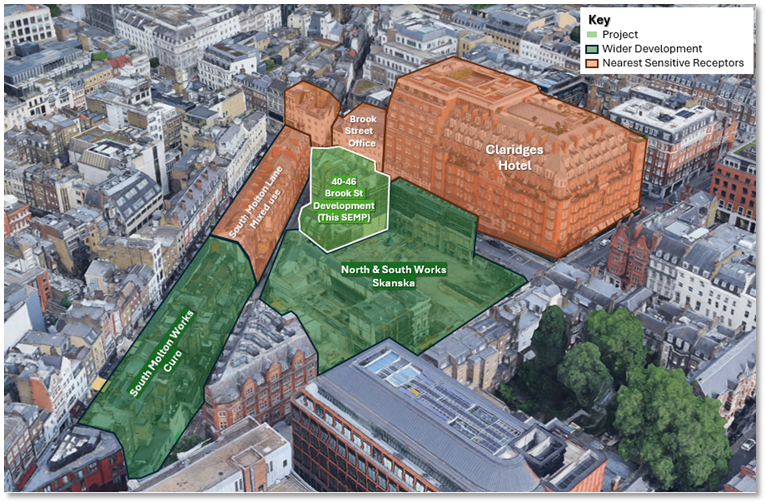

40–46 Brook Street forms part of the prestigious South Molton Triangle redevelopment in the heart of Mayfair. Toureen Contractors were appointed to deliver the enabling and structural refurbishment works required to transform the existing building into a high-quality boutique hotel development.
The project involves the careful refurbishment and adaptation of the existing structure within a constrained and highly sensitive central London location. Working within the established streetscape of Mayfair, the works require detailed planning, close coordination, and a considered approach to logistics and delivery. Once complete, the redevelopment will contribute to the wider regeneration of the South Molton area, creating a premium hospitality destination within one of London’s most prominent districts.
Project Update
Works progressing well and are on programme – Enabling works to complete Q3 2027.
All licences and permissions now in place with WCC.
Soft strip complete throughout the buildings.

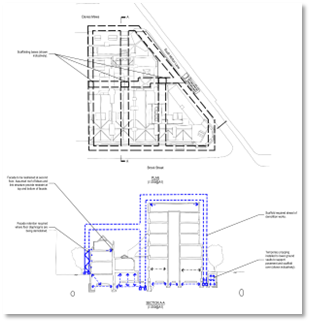

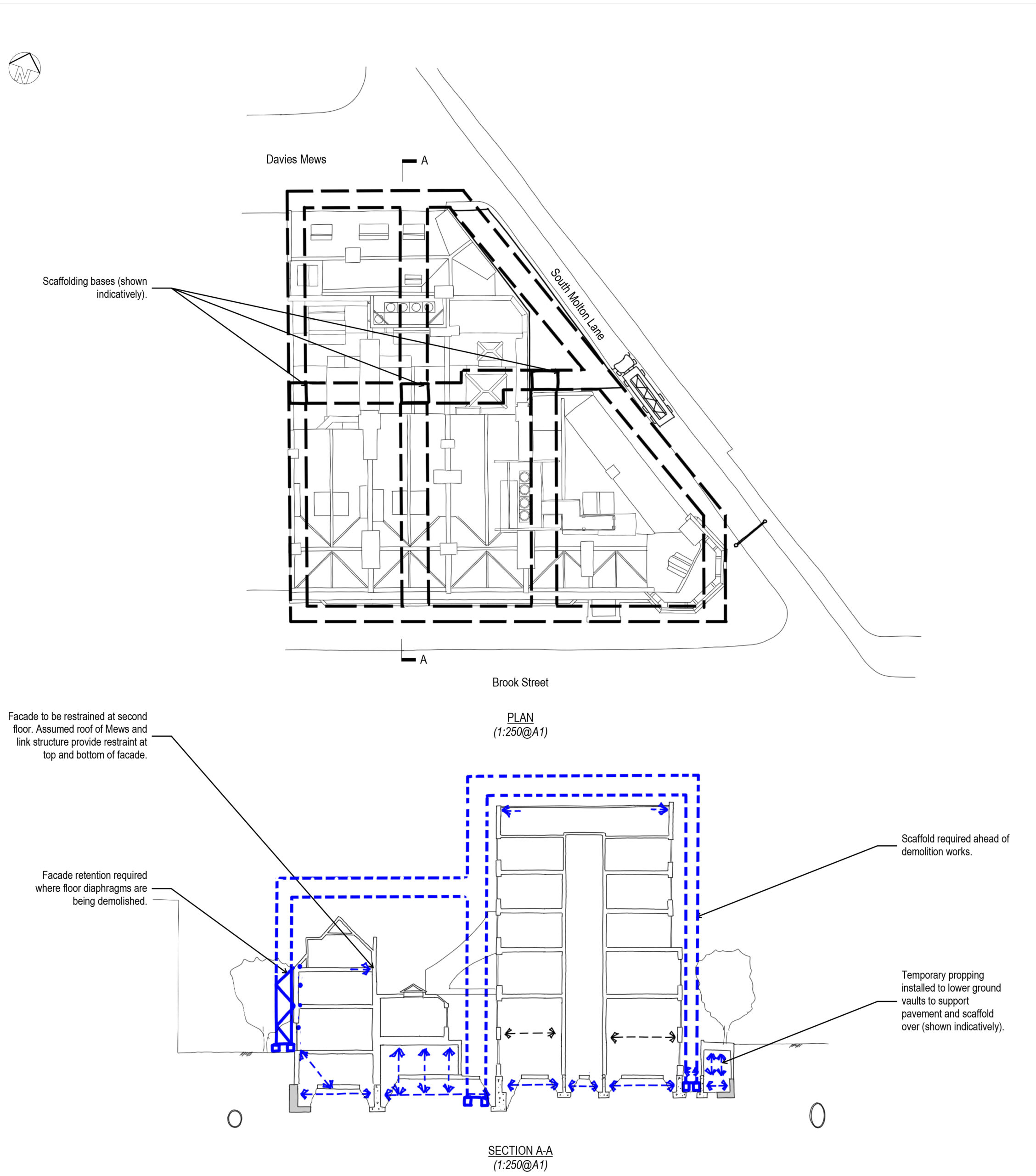

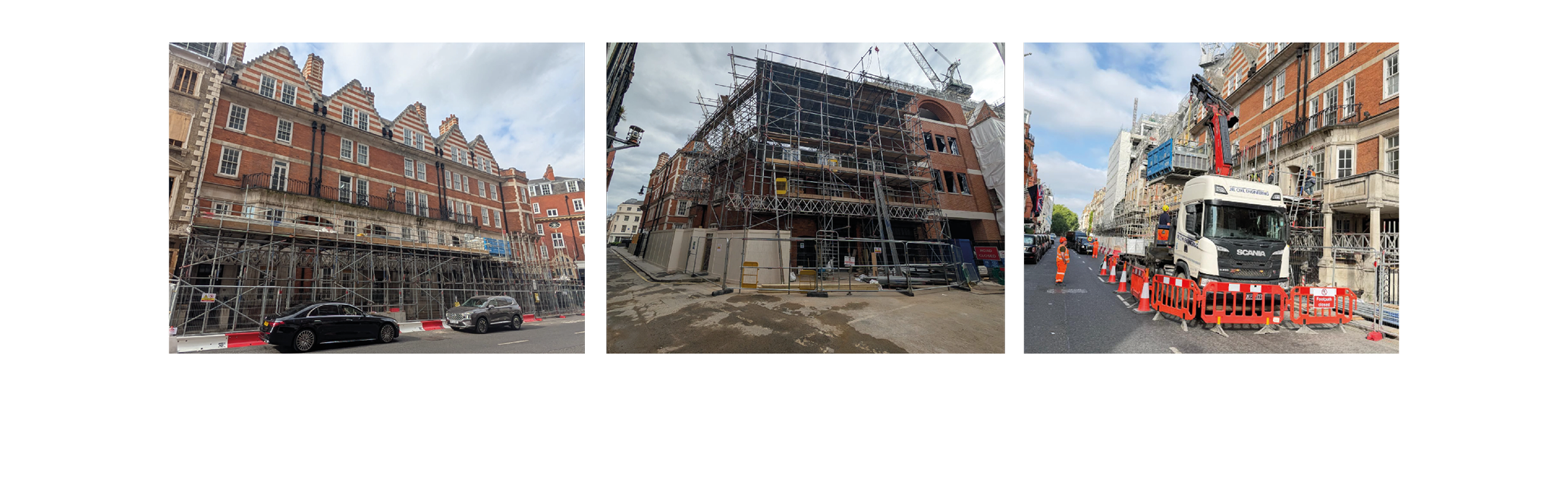

Scaffolding – On Brook St, SML and Davies Mews. Hoist installation now in progress – critical for superstructure structural alteration works.
-
Temporary works installation to support the building during the works commenced in July.
-

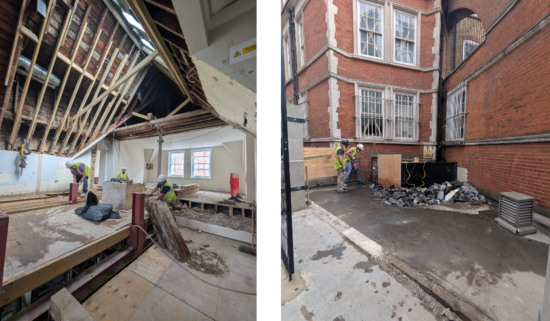

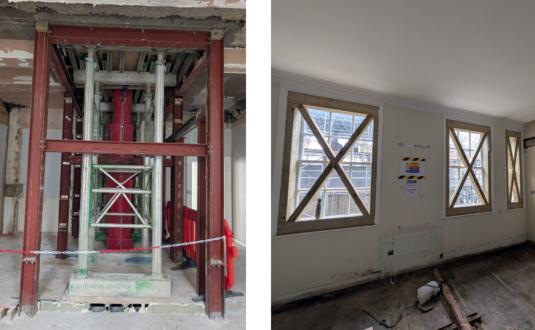

Demolition within the building underway with removal of existing lift structure and GF slab for basement access
Upcoming work:

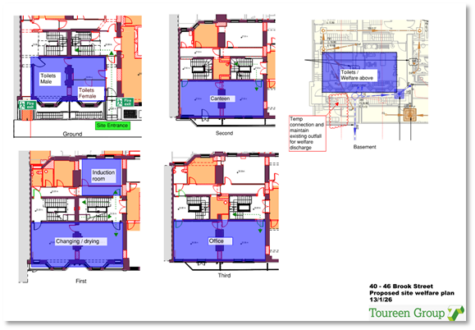

We have now commenced on site with setting up welfare facilities within the building, with the aim of commencing scaffolding in early June 2026.
-

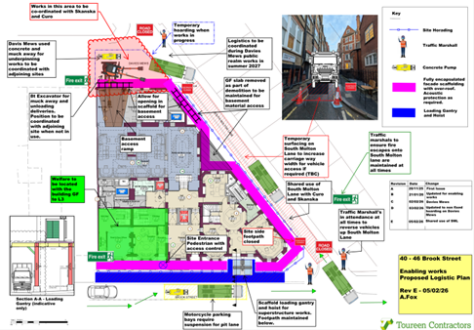

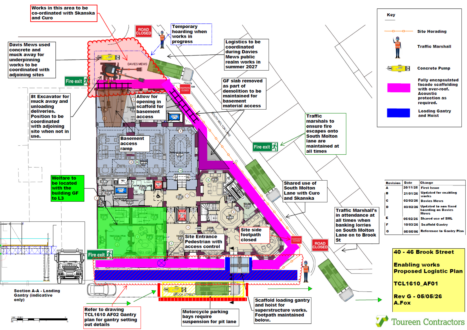

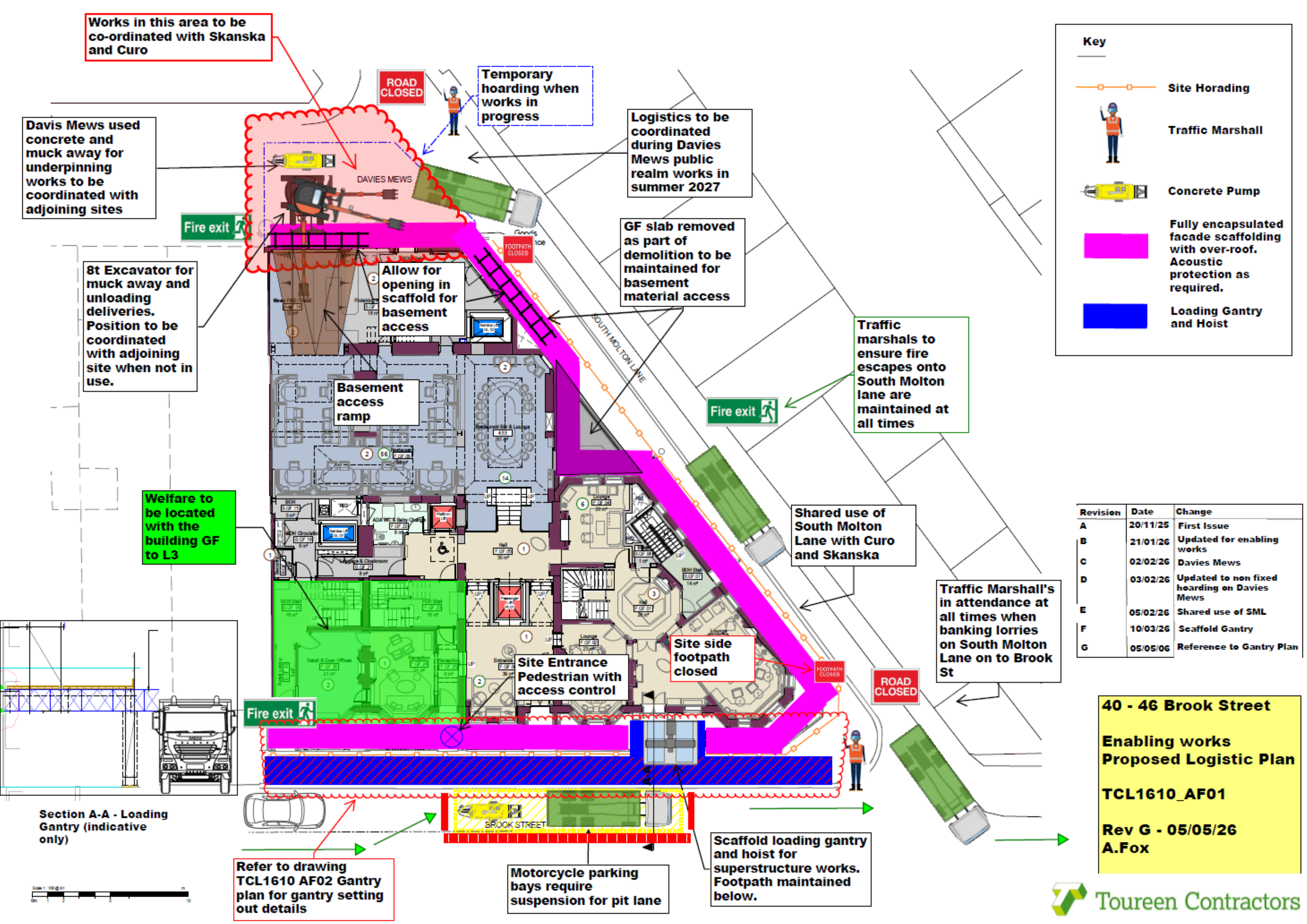

Construction Logistics
Deliveries will be managed in accordance with our approved Construction Logistics Plan.
Key points:
- Access via Brook Street pit lane and South Molton Lane
- Traffic Marshals managing vehicle movements
- No vehicle queuing on the public highway
- Wheel cleaning and highway protection
-
Completion of the scaffolding, hoarding, green hoarding on Brook Street and the re-opening of the footpath. Apologies for the disruption.
Installation of the scaffold roof.
Ongoing demolition and structural alterations within the building
Underpinning of existing basement to commence in August ‘26
Noise, Dust & Vibration Control
For the duration of the works Toureen will:
- Operate under Section 61 consent
- Apply Best Practicable Means (BPM)Undertake real-time 24hr monitoring
- Restrict high-impact works to core hours
- Coordinate with adjacent South Molton phases
Community Engagement
We are committed to engaging positively with our neighbours and will attend the monthly South Molton Community Liaison Meetings.
Details of next meeting can be found here on the link below.
In addition to providing updates on this webpage as the project progresses, we will keep surrounding residents and businesses informed of key milestones, project updates, and advance notice of any potentially disruptive works via newsletters.
We are committed to responding promptly to any complaints or concerns. If you have any questions or require further information, please contact the project team using the details below.
- Attend South Molton Community Liaison Meetings
- Issue newsletters at key stages
- Provide advance notice of disruptive works
- Respond to complaints within 48 hours
Contact the Team
BrookStreetInfo@toureen.co.uk
Anita Nash
Project Manager & Resident Liaison
